Main Contractor

Source Companion

Abdelrhman Negm, then at ALEC

How ALEC calculated package progress from connected project data

ALEC connected package identity, planned dates, onboarding and Aconex drawing data in one matrix. Restricted working tables fed shared Morta and Power BI views, while the demonstrated Aconex refresh was inactive.

ALEC

Why MortaBring package details, planning dates and drawing progress together
Working viewPackage matrix
ReportingMorta views and embedded Power BI
Refresh conditionAconex connection showed inactive during the demonstration

ALEC's package matrix brought package identity, planned dates, onboarding and drawing delivery into one connected view. The teams maintaining those records could work in restricted tables while sharing progress through Morta views and Power BI.

Watch the original Community Showcase

Abdelrhman Negm on the right of a two-speaker Community Showcase layout, labelled with ALEC.
Abdelrhman Negm presented ALEC's package matrix at the Community Showcase.

Executive summary

ALEC combined a maintained package list with planner-supplied dates and weightings, recorded onboarding steps and shop-drawing metadata from Aconex. For onboarded packages, total, issued and approved drawing counts supported engineering-progress calculations. The project team and upstream participants could inspect progress and compare onboarding with planned dates through shared reporting views, while access to the working tables remained restricted. Abdelrhman Negm's showcase covered both calculated measures and manual updates. The intended daily Aconex refresh depended on the connection, which was marked inactive during the demonstration.

Project scale

  • 20 or 50-plus work packages: Abdelrhman's scale examples for the packages ALEC could need to track as projects progressed.

The package matrix connected different inputs

Tracking a package involves more than recording its latest percentage. Its subcontractor details, planned dates, completed onboarding steps and drawing status each answer a different part of the progress picture. ALEC's matrix connected those inputs while retaining the tables and contributions that supplied them.

Excerpt of ALEC's table map showing the orange package-tracker block, its named views and connecting select and table-join lines.
The package-tracker block lists planning, mobilisation and progress views within ALEC's wider table map.

Keep package identity tied to the project-team table

The project-team composition table held the package list and the subcontractor names and contact details added during onboarding. The matrix's package-name field selected from that list, bringing the package and its associated organisation into the tracker.

A change in commercial strategy could add another package. Abdelrhman would first update the project-team composition table, making the revised package available to the matrix. The source list determined which package identity the tracker could use.

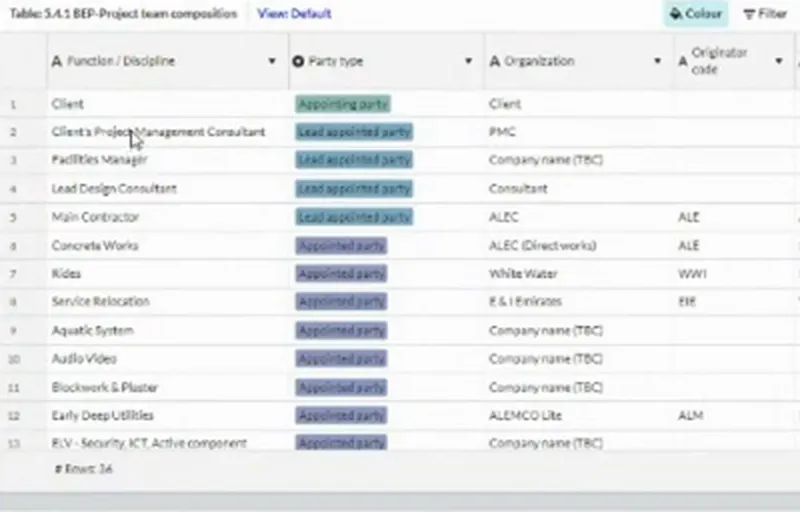

Project-team composition table excerpt showing functions or disciplines, party types, organisations and organisation codes.
The project-team table linked functions and packages to organisations. Contact details were held in columns outside this excerpt.

Compare onboarding with the plan

Planners supplied a weighting and dates for each package. The dates covered planned onboarding, the package kick-off meeting, engineering, construction and handover. These planning inputs sat alongside the package's onboarding tracker.

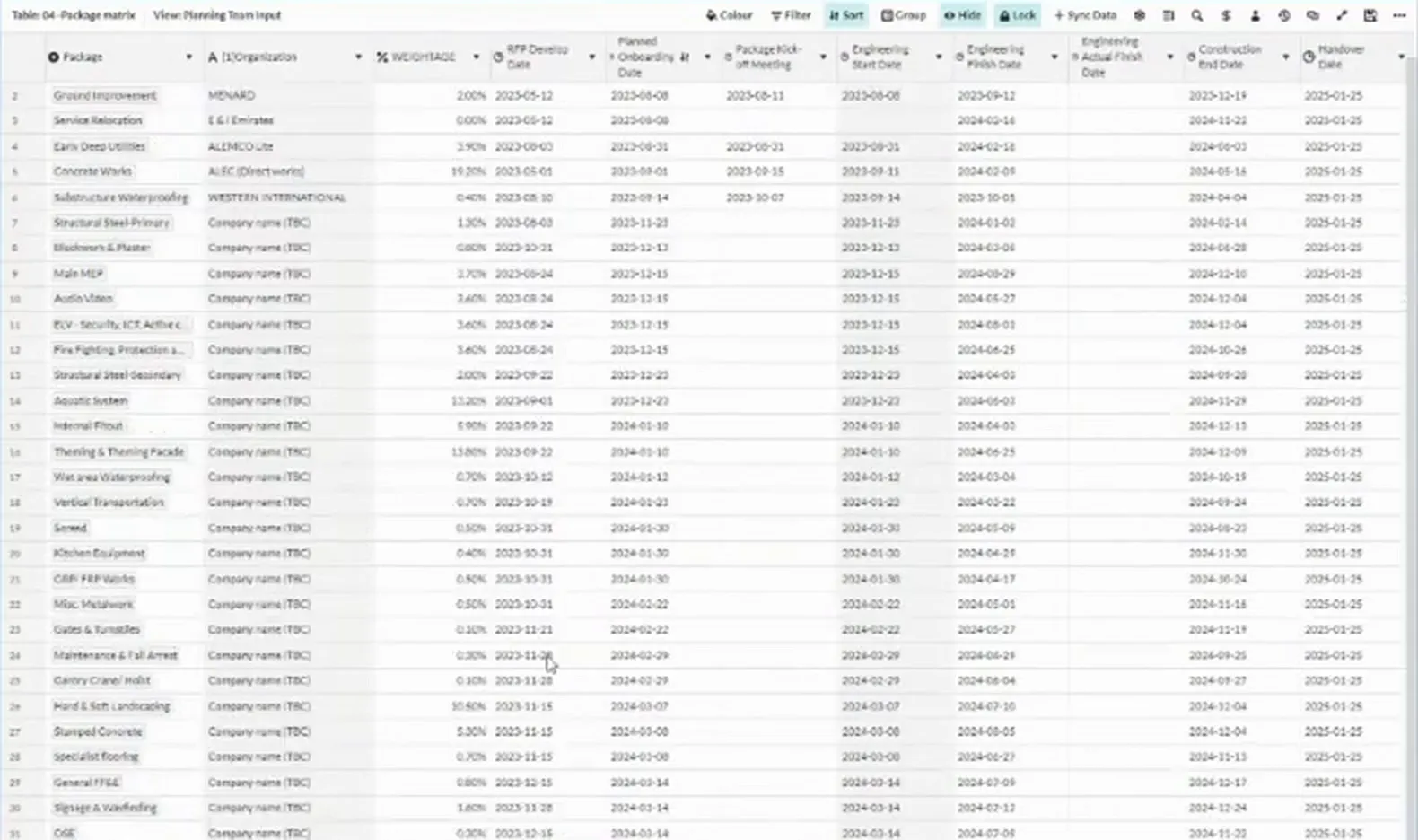

Package matrix planning view with package names, organisations, weightings, and planned and actual date columns.
Planners supplied the package weightings and dates used alongside onboarding updates.

As each onboarding step was completed, Abdelrhman updated it in the matrix. The team could compare those recorded steps and the resulting mobilisation status with the planned onboarding date. A planned onboarding date sets the expected timing. Completed steps show how far the package has progressed through onboarding.

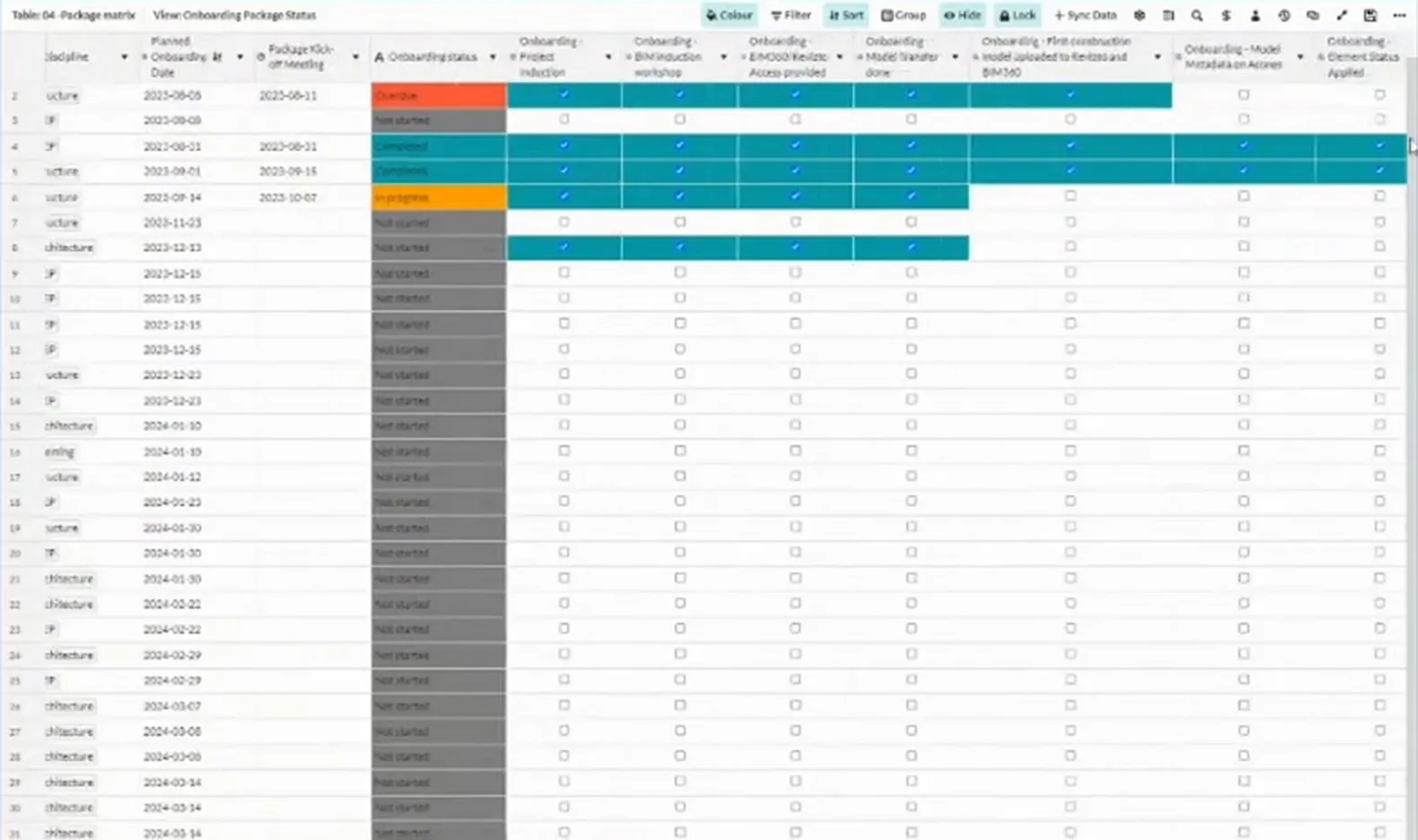

Onboarding table with planned dates, coloured status fields and checkboxes for individual completed steps.
Recorded onboarding steps sat alongside planned dates, allowing the team to compare mobilisation with the plan.

Read engineering progress against expected drawings

The expected drawing set gives issued and approved counts their context. ALEC's QA/QC approach registered shop drawings still to be produced as well as those already produced, with their metadata held in Aconex.

For onboarded packages, the matrix brought together total, issued and approved shop-drawing counts and calculated engineering-progress measures. The project team could inspect drawing delivery against the package's expected documents, including the distinction between drawings issued and drawings approved.

These measures concerned engineering drawing delivery. Construction progress appeared as a separate category in the wider report.

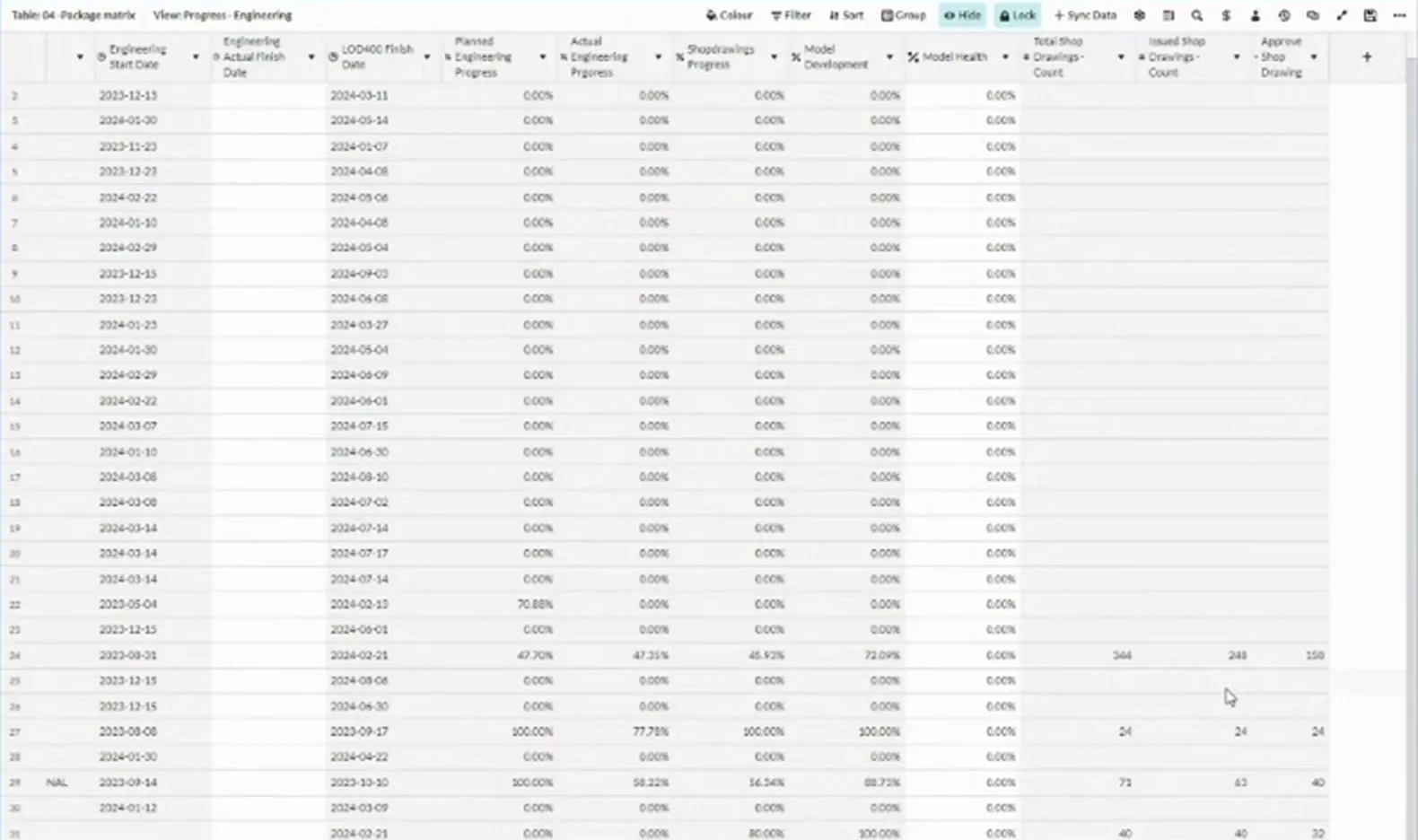

Engineering view showing progress fields and columns for total, issued and approved shop-drawing counts.
The engineering view brought together expected, issued and approved shop-drawing counts and calculated progress fields.

Abdelrhman described a daily Aconex refresh but noticed that the integration was marked inactive during the demonstration. The calculation and the supply of refreshed document data remained distinct parts of the setup.

Share progress without opening every working table

The people maintaining package information needed access to the working tables. Abdelrhman named planners, commercial colleagues and the digital delivery team among those who might require it. The reporting audience was wider.

The progress is meant to be shared with everyone.

Abdelrhman Negm

ALEC shared mobilisation status and appointed-party progress through Morta views. These let the team and upstream participants inspect the packages and compare onboarding with planned dates without opening every underlying table.

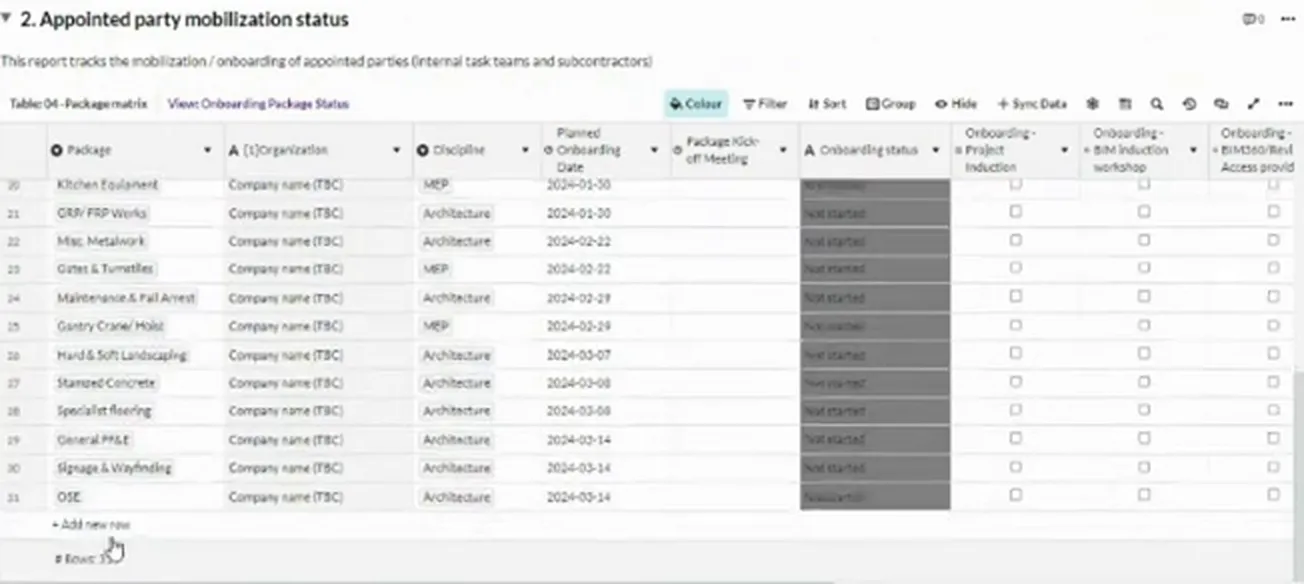

Mobilisation report showing packages, organisations, disciplines, planned onboarding dates and onboarding status.
The shared mobilisation view put each package's planned date alongside its onboarding status.

Data also went into Power BI, with the report embedded back into Morta. Its charts brought different aspects of package progress together for the reporting audience. Some contributions remained manual, including the onboarding updates, alongside the calculated measures.

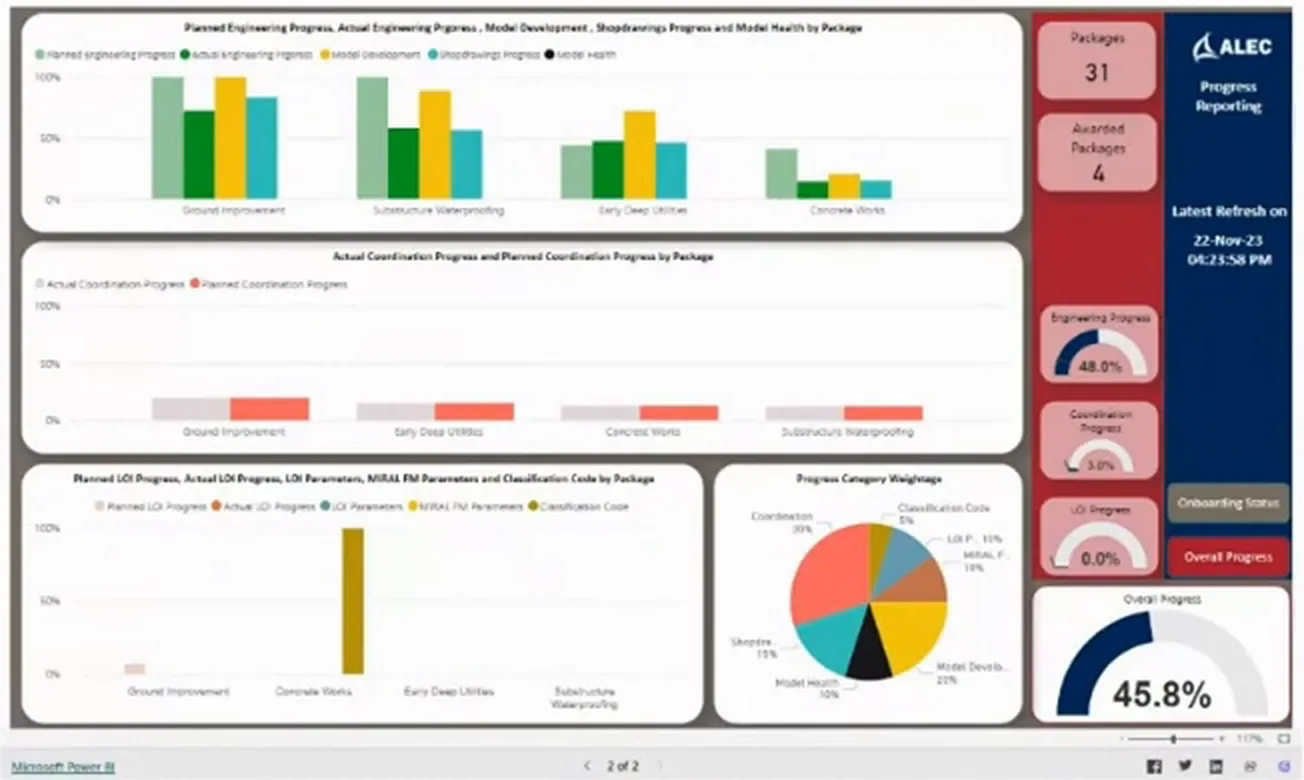

ALEC dashboard with package bar charts, progress-category weightings and separate engineering, construction, information and overall progress gauges.
ALEC embedded Power BI reporting in Morta, with separate categories for the different aspects of package progress.

Keep the growing setup understandable

Abdelrhman and Andy Boutle sat down together to understand the table relationships they had built. Andy created the map, which helped them see how the background tables connected as they continued developing the setup. The map was part of that continuing work, with the connected resources still growing.
