Bouygues TP Murphy JV
On the Lower Thames Crossing, you cannot create a deliverable in Asite or ProjectWise unless you go through Morta. Thibaud Guerrero and Ioan Evans built it that way deliberately , and then expanded brick by brick into consent tracking, procurement, temporary works, carbon management, and programme visualisation.
Executive summary
The Lower Thames Crossing is a major UK infrastructure project featuring twin-bored 4.2km tunnels connecting the A2/M2 to the M25. The Bouygues TP Murphy JV (contractor) and ARUP/Mott MacDonald JV (designers) adopted Morta as a plug-and-play collaborative platform to bridge the gap between enterprise systems and Excel. Starting with information delivery planning as the foundation, they expanded brick by brick into consent tracking, procurement, temporary works, carbon management, and programme visualisation , all built on shared standards, shared ownership, and a unified component catalogue.
We really tried to start on good foundations. If we don’t make the effort to make sure the design is done correctly and our information is managed, it’s really hard to do any other things.
Thibaud Guerrero, Bouygues TP Murphy JV
The results
Morta became the entry point for all deliverables on the project , you cannot create a document in Asite or ProjectWise without first registering it in Morta, which is the key to maintaining a single source of truth across two CDEs and two JV organisations. Document codes are managed centrally to prevent duplicates, and user profiles determine which CDE receives each deliverable.

By syncing P6 data into Morta, the planning team , now one of the biggest user groups , can reorganise, filter, and enrich programme data without touching the master schedule. Teams self-serve answers to common questions about submittal dates, consent timelines, and tendering schedules without burdening planners. The component catalogue ingests industry standards from bSDD, National Highways, Uniclass, and carbon requirements, and drives automated configuration of CAD/BIM software platforms to produce standards-conforming IFC 4x3 files.

From the MIDP foundation, the team expanded brick by brick into consent tracking, procurement management, temporary works packaging, and carbon reporting , each building on shared master data. Rather than centralising all Morta work, the team established digital champions across functions who build and own their own solutions. When something gets defined once in Morta, it is defined once and reused across everything , spatial locations, site activities, plant, equipment, people , eliminating the constant reinvention that plagues large infrastructure projects.
People have ownership of what they’re doing. They can create their own views, they can organise their information. If we’re trying to replace Excel, we can’t say stop using Excel but at the same time you’re not going to use Morta.
Thibaud Guerrero, Bouygues TP Murphy JV
The challenge
There is a persistent gap in the industry between advanced enterprise systems , data warehouses, AI, drones , and the reality of day-to-day project work where Excel still dominates. Neither extreme served the team’s needs for accessible, collaborative data management on a project of this scale.
The Primavera P6 programme is an excellent tool for what it does, but extracting and sharing information from it was always challenging. The planning team was constantly fielding ad-hoc questions from hundreds of stakeholders, taking time away from maintaining the programme and interacting with production teams. Different teams referred to the same things by different names , on previous projects like HS2, asking what the South Portal was to different departments always produced different answers.
Two separate JV organisations needed to align on standards, naming conventions, column headers, RAG colours, navigation, and processes from day one , all while using different CDEs. With ProjectWise and Asite running in parallel, there was significant risk of duplicate document codes, inconsistent naming, and fragmented information unless a single entry point controlled creation across both systems. And as teams saw the potential, there was an initial temptation to do everything in Morta immediately , without governance, teams could develop independently and miss the chance to share standards and reuse data.
You cannot create a deliverable in Asite or ProjectWise unless you go through Morta. It’s the entry point to everything, and it’s our key to maintain that source of truth.
Thibaud Guerrero, Bouygues TP Murphy JV
The solution

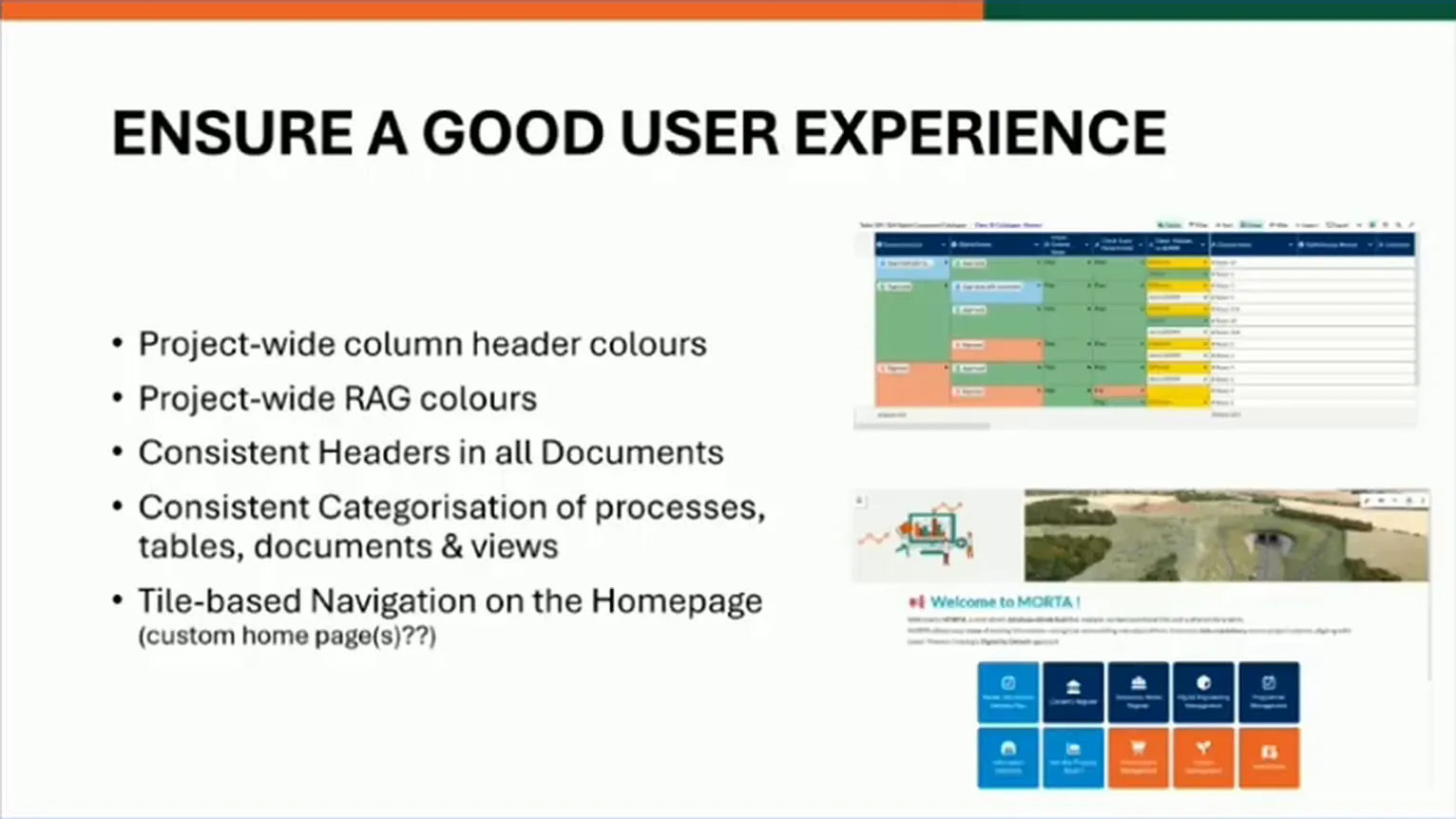

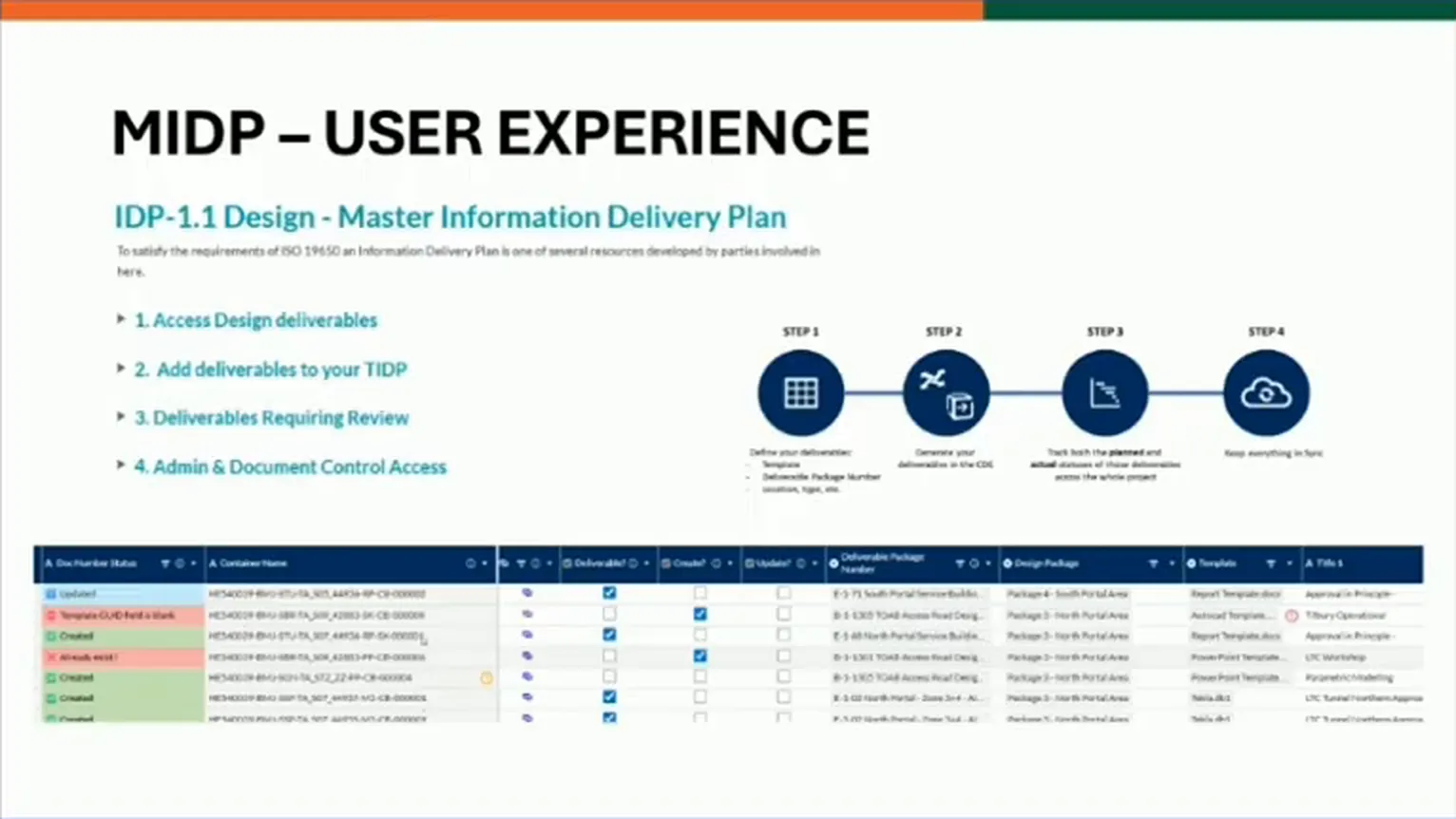

The team chose Morta for its plug-and-play nature , unlike enterprise solutions requiring months of IT setup, ETL pipelines, and data warehouse configuration, Morta delivered value immediately. The contractor and designer JVs had admin rights from day one and built the system together, establishing consistent column header colours, RAG colour standards, categorisation conventions, naming standards, and tile-based navigation for the landing page.

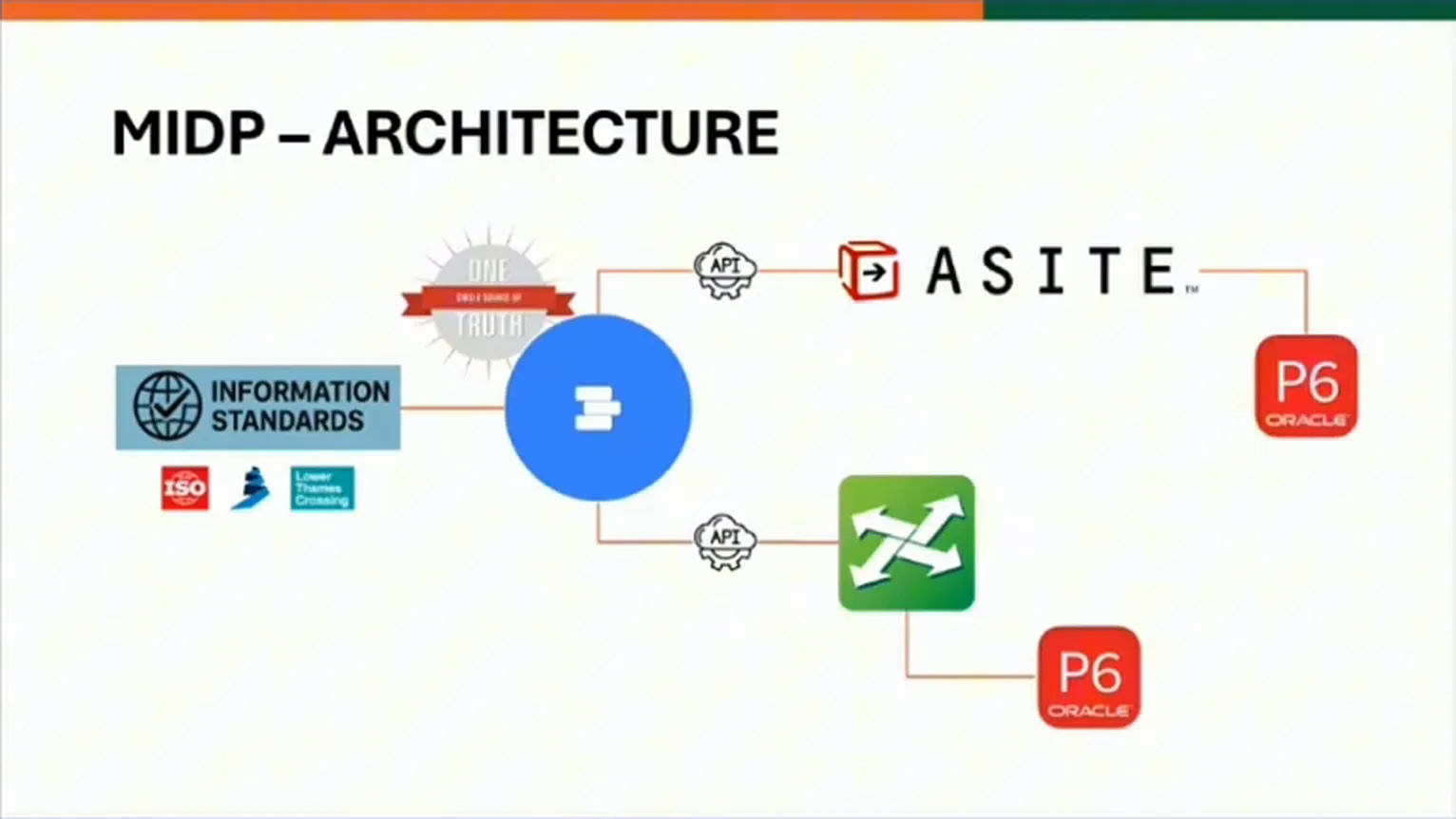

The MIDP drives CDE creation , you cannot create a deliverable in Asite or ProjectWise without first registering it in Morta. Document codes are managed centrally to prevent duplicates, and user profiles determine which CDE receives each deliverable. The project component catalogue was built in Morta by ingesting industry standards and requiring every discipline to create their components within the system, driving automated CAD/BIM software configuration and IFC 4x3 file delivery.

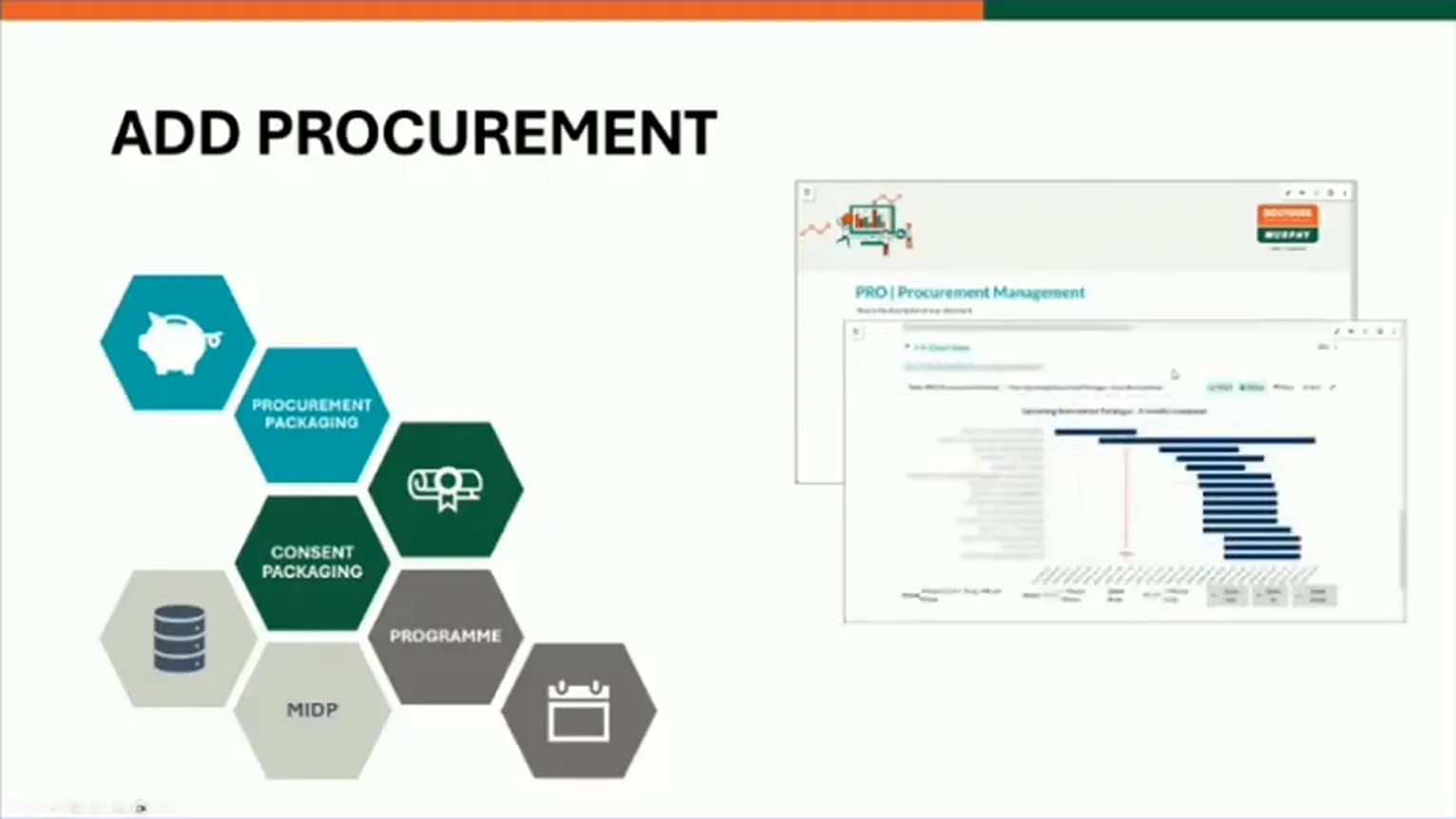

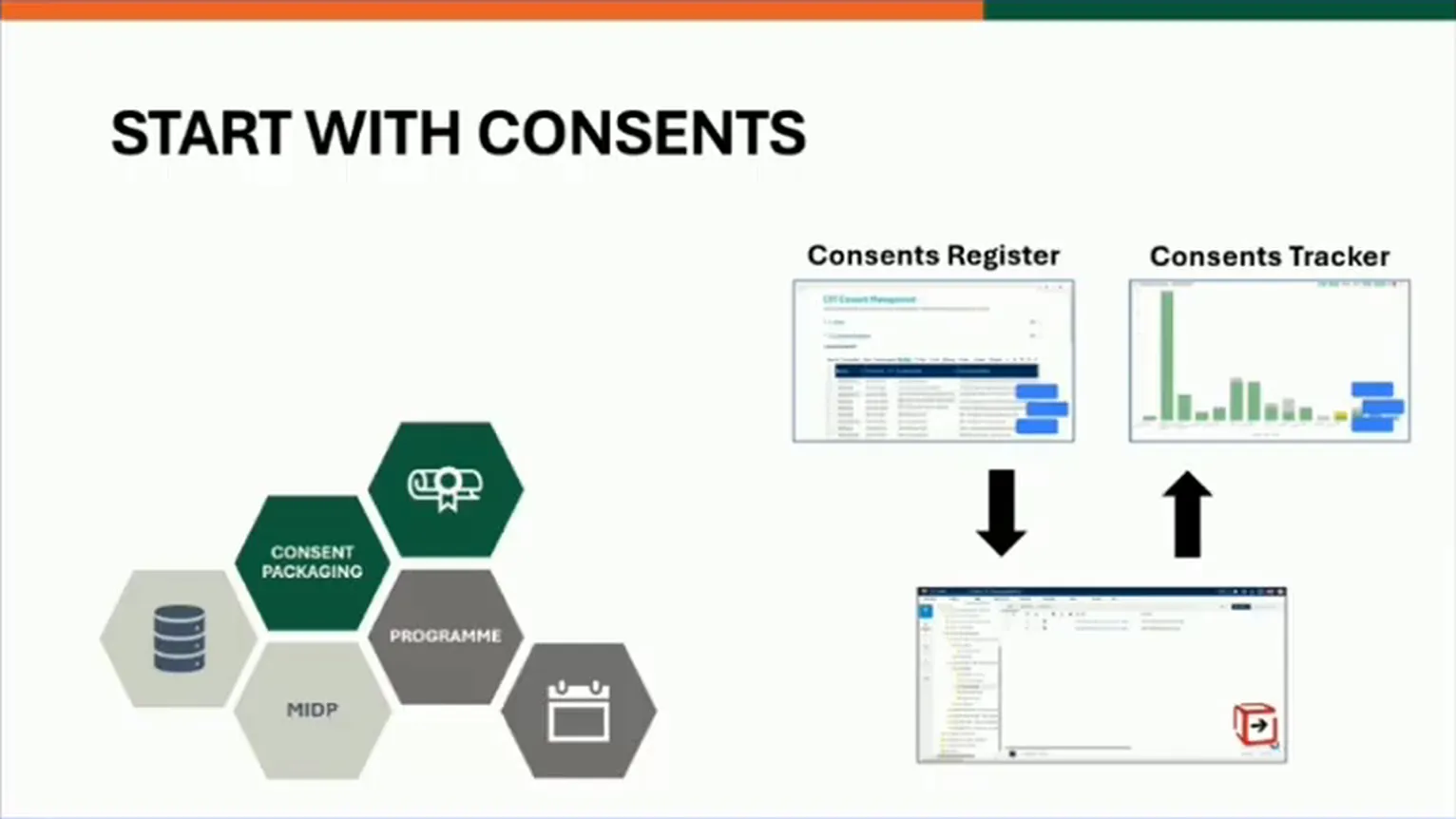

P6 data synced into Morta allows the planning team to reorganise, filter, and enrich programme data without touching the master schedule. Rather than trying to do everything at once, the team deliberately added use cases one at a time , consent tracking, procurement, temporary works, carbon , each building on shared master data and proven foundations. Five criteria determine whether a use case belongs in Morta: Is it a new data set? Will it interact with other data sets? How is it being shared? Does it need permission management? How is it being tracked?
The implementation
Both the contractor and designer JVs had admin access from day one and built the system collaboratively, ensuring shared ownership and consistent standards from the outset rather than one party imposing their structure on the other. They developed tile-based navigation for the landing page, consistent column header colours across all documents and tables, standardised RAG colour schemes for validation, and clear naming and categorisation conventions.
Both the AMDG designer TIDPs and BMJV contractor TIDPs are managed in Morta, along with supply chain TIDPs. The process ensures document codes are unique across both CDEs and that user profiles route deliverables to the correct system. The team ingested bSDD, National Highways standards, Lower Thames Crossing-specific requirements, Uniclass codes, and carbon requirements into Morta, and each discipline created their components within this framework.
Rather than centralising all Morta work in the digital team, the project trains digital champions across different functions who build and maintain their own solutions. People have ownership of what they’re doing , they can create their own views and organise their information. The team actively communicates with the Morta community, sharing custom solutions and advocating for features to be incorporated into the core product. The flexibility of Morta is powerful, and as Thibaud notes, getting the most out of it rewards a high level of organisation and vision from the start.
Before & after
Planning team constantly fielding ad-hoc questions
Teams self-serve answers from P6 data synced into Morta
Risk of duplicate document codes across 2 CDEs
Single entry point controls creation across Asite and ProjectWise
Different teams referred to the same things by different names
Component catalogue defines things once, reused across everything
About Bouygues TP Murphy JV
Bouygues TP Murphy JV is the joint venture delivering the tunnel approaches section of the Lower Thames Crossing, a major UK infrastructure project.
Want to see how this could work for your projects?
Frequently asked questions.
Common questions about this template and how it works.
How does Morta work across a joint venture with multiple CDEs?
On the Lower Thames Crossing, the contractor JV uses Asite while the design JV uses ProjectWise. Morta sits above both as the single source of truth for deliverable planning. TIDPs in Morta drive CDE creation , document codes are managed centrally to prevent duplicates across systems, and user profiles determine which CDE a deliverable is created in.
What is the "to Morta or not to Morta" framework?
The team developed five criteria for deciding whether a use case belongs in Morta: Is it a new data set? Will it interact with other data sets? How is it being shared (internally/externally)? Does it need permission management? How is it being tracked? If most criteria are met, it goes into Morta.
How does Morta help free the P6 programme?
P6 data is synced into Morta, allowing the planning team to reorganise, filter, and enrich programme data without touching the master programme. Teams can self-serve answers to common questions (submittal dates, consent timelines, tendering schedules) without burdening the planning team, while Morta feeds into Power BI for milestone visualisations and programme-on-a-page reports.
